McLeod Avenue

Progress Report – Retaining Wall RW064 Replacement – Mcleod Avenue
This past week: July 6-10, 2026

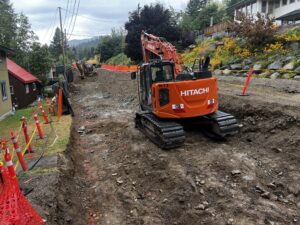

  • Contractor Mobilization
  • Road Closures established

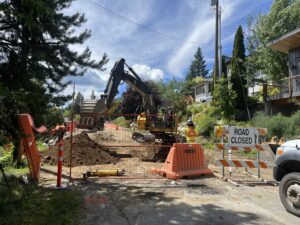

  • Asphalt removal

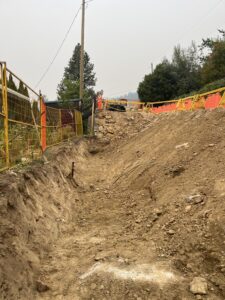

  • Utility Locates

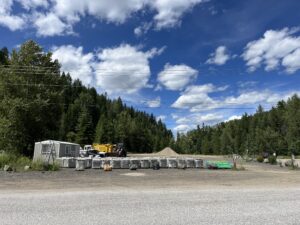

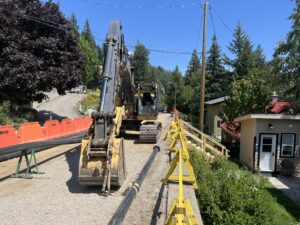

  • Wall material delivered to laydown area

Next week: July 13 – 17

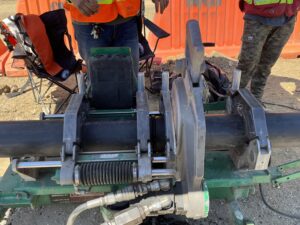

  • Temporary water bypass installation – water disruptions expected later in the week.
  • Affected residents will be notified once schedule is confirmed.

    Municipal Services: Public Works

Josh Solman

Deputy Operations Manager

Email: deputy.operations@rossland.ca

Phone: 778-457-6624

STATUS:  In Progress

RW064 – Retaining Wall & Associated Utilities Replacement (McLeod/Washington)

This section on McLeod is located at the top of Washington and McLeod.

What’s happening?

The City is undertaking remediation work on Retaining Wall RW064 on McLeod Avenue to address structural deterioration and ensure long-term stability. The project includes replacing the existing wall to maintain the integrity of the roadway, protect city infrastructure and adjacent private properties. In addition to the wall, 68m of watermain will be replaced during the during the process.

Why is this important?

The retaining wall plays a critical role in supporting the roadway, infrastructure, and preventing slope movement. Addressing the deterioration now helps reduce the risk of future failure, protects public safety, and avoids more extensive and costly emergency repairs down the line.

Why do you need to replace the watermain?

Two reasons:

  1. The current watermain alignment is in conflict with the new walls anchor system.
  2. The existing AC watermain, and copper service connections, installed in 1961, are nearing the end of their service life and are due for asset renewal.

Is McLeod going to be closed to traffic?

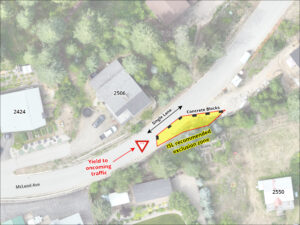

Yes – a section of it will be, as shown in the map, the area will be closed to all traffic and pedestrian access – there will be access allowance for directly impacted homeowners only.

What is the expected timeline for this project?

The contract has been awarded to Copcan Civil LP.  Work is anticipated to begin July 6th and is expected to be completed mid September 2026, pending site conditions and weather.

How do I know if the wall near my house is safe?

The City completes routine retaining wall inspections throughout the City, including visual assessment by a structural engineer, and digital scanning to identify subtle settlements.  This remediation project is a direct result of this ongoing monitoring program.

How is it being funded?

The project is funded through the City’s 2026 Capital Budget, supported by general municipal taxation for ongoing infrastructure renewal.

Related documents

RW030 – McLeod Avenue Partial Road Closure – Near the entrance to the Iron Colt Subdivision

The City of Rossland is implementing a temporary traffic pattern change on McLeod Avenue, near the entrance to the Iron Colt subdivision, due to observed movement in the retaining wall that supports the roadway. See map below.

What’s happening?

  • A partial lane closure and traffic-calming measures will be introduced (see picture above).
  • These precautions are necessary to ensure longevity and stability whilst planning the remediation works.

Why is this important?

  • The temporary single-lane configuration and exclusion zone are essential for the safety of all road users.
  • City staff are actively monitoring the situation and developing detailed plans for permanent repairs.

How long will this last?

  • These measures will remain in place until permanent repairs are complete.

Updates will be provided as available.
